Gantt

Gantt renders tasks as horizontal bars on a timeline, with dependencies shown as arrows between bars. It's a project-level timeline view — useful for project planning and seeing critical paths. Available on Pro and above.

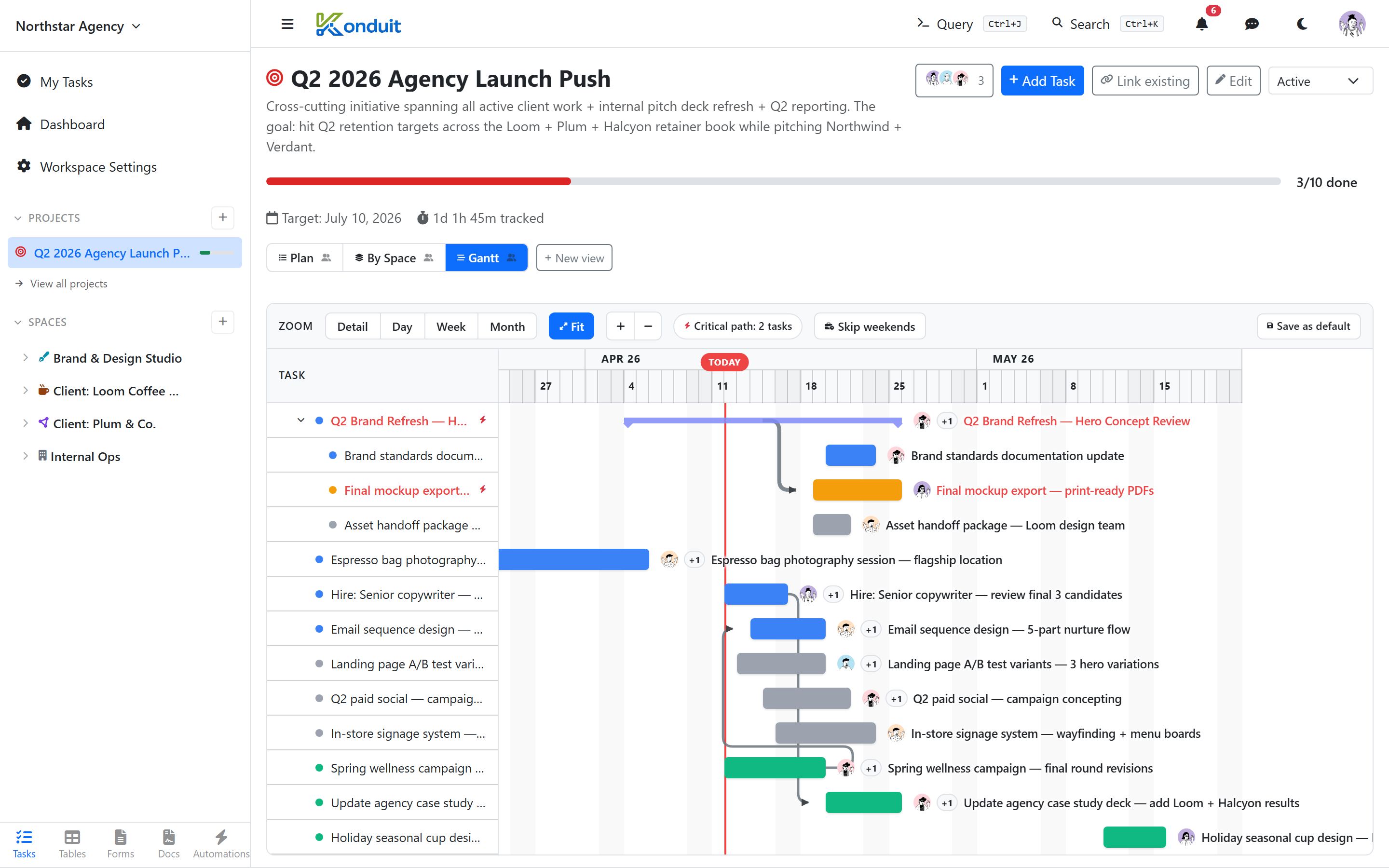

gantt view with multiple tasks and dependency arrows

What appears

Tasks need at least a start date or due date to appear on the gantt. Tasks with both render as a range; tasks with only a due date render as a milestone diamond on that day.

Dragging

  • Drag the bar body — shift the entire range
  • Drag the left edge — change start date
  • Drag the right edge — change due date
  • Drag the name column — reorder rows

Dragging only moves/resizes existing bars, draws dependencies from bar edges, or reorders rows — there's no drag-in-empty-space task creation.

Zoom levels

The toolbar offers four zoom presets, plus a Fit button and a +/- stepper for fine control.

Zoom Best for
Detail Hour-level detail, tightly-scheduled work
Day Sprint planning, near-term work
Week Multi-week initiatives
Month Quarterly and roadmap-level views

Dependencies

Drawn as arrows from "blocking" → "blocked by" task. Drag from the right edge of one bar to the left edge of another to create a dependency. See Dependencies for the full model.

Critical path

Tasks on the critical path (longest dependency chain to project completion) get a subtle highlight. Useful for spotting bottlenecks.

Row organization

The Gantt has no group-by control. Bars are organized by the task/subtask hierarchy. (The project's separate By Space view tab groups work by space, but that's not a Gantt grouping.)

Limitations

Gantt works smoothly up to around 500 tasks. For larger plans, filter to the relevant subset.
